The Pre-Construction Workflow That Separates Profitable Builders From the Rest
Jacob Campbell • September 21, 2026


Profit on most Australian builds is determined before site works start. Every decision made — or skipped — in the pre-construction phase compounds through the project. Builders who treat pre-construction as a structured, disciplined phase consistently deliver better margins than builders who treat it as a sprint to get to site.
This article lays out a five-phase pre-construction workflow used by some of the most profitable mid-market residential and commercial builders in Australia. It's designed to professionalise what is often the most chaotic phase of a build.
Why Pre-Construction Is the Highest-Leverage Phase of Any Build
There's a hierarchy of cost-control leverage in construction, and it inverts as the project progresses:
- Lead qualification: every dollar of estimating effort spent on a job you shouldn't have quoted is wasted
- Feasibility and design: decisions here lock in 60–70% of project cost
- Estimating: where margin is priced in or out
- Contract: where margin is protected or exposed
- Site works: where margin is delivered or eroded — but the ceiling has already been set
By the time the first concrete pour happens, the maximum margin you can earn on the project has been determined. Site execution can lose margin from there, but it can't add to what wasn't priced in.
This is why the most profitable builders aren't necessarily the best site managers. They're the best pre-construction operators.
The Five Phases of a Strong Pre-Construction Workflow
Each phase has defined inputs, defined outputs, and defined ownership. The goal isn't bureaucracy — it's predictability.
Phase 1: Lead Qualification
Most Australian builders quote too many jobs. Quoting is expensive — typically 1–3% of the contract value in time and resource cost. Quoting jobs you shouldn't have quoted is a major source of estimating overhead, and it dilutes attention from the jobs that matter.
What Lead Qualification Looks Like
Before any estimating begins, the lead is assessed against a defined qualification framework:
- Project type fit: does this match what we do well?
- Geographic fit: is this within our operational radius?
- Budget reality: does the client's budget align with the scope they're describing?
- Decision-maker access: are we talking to someone who can actually award the contract?
- Timeline reality: is the project ready, or are we quoting a wishlist?
- Competitive context: how many other builders are quoting, and what's our likely win probability?
The Output: Go / No-Go Decision
Every lead either passes qualification and moves to feasibility, or fails and gets a structured no-thank-you (which often becomes a referral). Builders who implement this discipline typically reduce quote volume by 30–40% while increasing win rate and margin per quoted job.
Phase 2: Feasibility
For qualified leads above a defined complexity threshold, a feasibility step happens before full estimating begins. Feasibility is a lightweight assessment that answers: "Can this project actually be built within the client's budget and timeline expectations?"
What Feasibility Include es
- Site visit and constraint review (access, services, soil, vegetation, neighbours)
- High-level cost estimate (square metre rate or first-principles benchmark)
- Identification of major cost drivers and risks
- Programme overview (typical duration for a project of this type)
- Honest conversation with the client about budget vs. scope
Why Feasibility Saves Money
Feasibility kills bad jobs early. A two-hour feasibility review can prevent a 40-hour estimating effort on a project that was never going to proceed at the client's stated budget. It also positions you as a strategic partner rather than just another quoter — which often becomes the differentiator that wins the eventual contract.
Phase 3: Estimating
This is the most-discussed phase but it's only one of five. The estimating process should follow your documented take-off and pricing protocols, with appropriate review and quality control. The output is a quote that genuinely reflects the cost of delivering the project to the standards specified, plus your overhead and profit.
What Strong Estimating Looks Like in Pre-Con
- Documented take-off process (see the take-off process article)
- Explicit scope-of-works with inclusions/exclusions schedule
- Subcontractor pricing in writing for trades above threshold
- Updated rate library reflecting current market conditions
- Two-pass review before quote submission
- Documented assumptions, allowances, and PC sums
Phase 4: Contract
The contract phase is where pre-construction discipline either pays off or unravels. Many builders rush this phase because the client wants to start. That's a mistake. The cost of three days of additional contract clarity is usually less than the cost of one disputed variation later.
Critical Contract Activities
- Contract type selection (HIA, Master Builders, custom) appropriate to the project
- Special conditions reviewed and customised for project-specific risks
- Inclusions/exclusions schedule attached as a contract appendix
- Programme attached and agreed
- Variation procedure documented and explicitly agreed
- Payment schedule aligned with construction milestones
- Insurance and warranty obligations confirmed
- Domestic Building Insurance (where applicable) arranged
Phase 5: Handover to Construction
The most overlooked phase. Most pre-construction problems that surface during the build trace back to a poor handover from the estimating team to the project management/site team. Information sits in the estimator's head and never makes it into a usable form for the people building the job.
What a Good Handover Looks Like
A formal handover meeting between the estimator and the project manager covers:
- Walkthrough of the estimate by trade, including key assumptions
- Review of all PC sums and provisional items, with action plans for resolution
- Subcontractor list and pricing context
- Programme and any commitments made to the client about timeline
- Known risks and how they were priced
- Margin position and where it's protected vs. exposed
The output is a project brief document that becomes the operating manual for the build. The estimator's knowledge transfers to the team, instead of evaporating after the contract is signed.

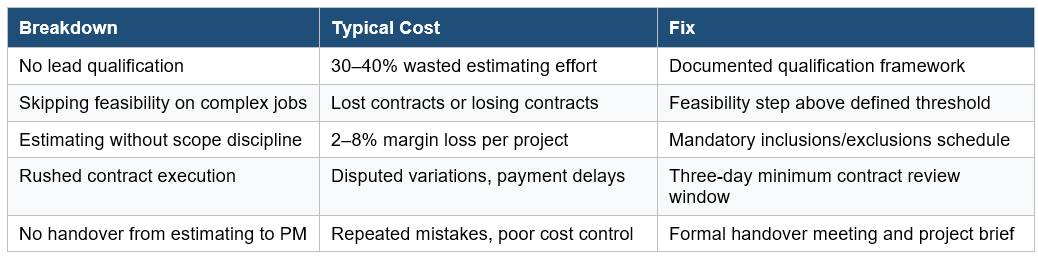

Common Pre-Construction Breakdowns

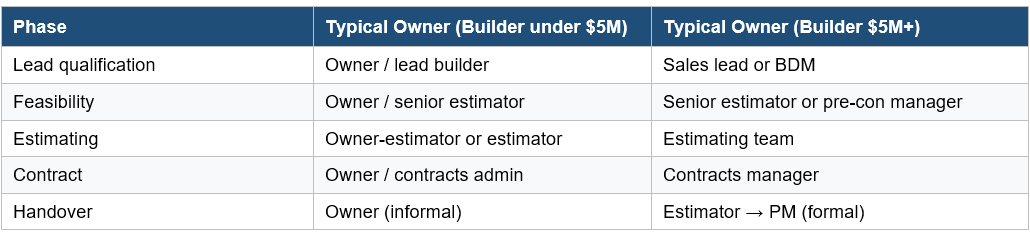

Roles and Ownership
A pre-construction workflow only functions when each phase has clear ownership. In smaller builders, one person may own multiple phases — but the phases still need to be distinct activities, not blended into a single "pre-con" blob.

How Software Supports the Workflow
Pre-construction is mostly a process discipline, but software accelerates it significantly. Modern construction management platforms (Wunderbuild, Buildxact, and the contract-side tools like Workbench) provide:
- Lead and pipeline tracking for qualification visibility
- Estimating templates and cost libraries that enforce consistency
- Document control for drawings and revisions
- Direct flow from estimate to project setup, eliminating handover loss
- Variation tracking that ties back to the original estimate
KPIs to Measure Pre-Construction Performance
- Quote-to-feasibility conversion rate (what % of qualified leads make it to feasibility?)
- Quote win rate (industry average is 20–30%; mature builders track this by lead source)
- Margin variance — quoted vs. actual (target: <2% variance on completed projects)
- Variation rate (lower variation rates indicate stronger pre-construction)
- Pre-construction duration (consistent timing indicates a working process)
How Pre-Construction Scales
Owner-led pre-construction works up to a point — usually around $3–5M annual turnover. Beyond that, the workflow has to be distributed across roles. Builders who try to scale without distributing pre-construction either burn out the owner or accept declining margin as the owner's attention spreads thinner.
The transition is the same one every growing builder eventually faces: from "I do all of pre-con" to "I run the system that does all of pre-con." That shift is the single most important growth move available to most Australian builders.
Builders who systemise pre-construction don't work harder. They work on a different kind of business — one where margin is protected by process rather than by personal heroics.
Want to map your pre-construction workflow against the five-phase framework above? Book a free pre-construction systems audit and we'll show you where margin is leaking before site works even start.
Ready to quote faster?
Book a free 15-minute call with our team and we'll show you how Campbells fits your workflow.
Book a Free CallLatest Posts
