First Principles Estimating vs Square Metre Rates: Which Method Actually Protects Your Margin?
Jacob Campbell • September 20, 2026


Ask ten Australian builders how they price a new home and you'll get ten slightly different answers. But underneath all of them, two fundamental methods are at work: first principles estimating, which builds the cost from the ground up, and square metre rate estimating, which applies a price-per-square-metre based on past experience or industry benchmarks.
Both methods are used. Both have legitimate applications. And both are misused in ways that consistently destroy margin. Understanding which method to use, when, and in what combination is one of the highest-leverage estimating skills an Australian builder can develop.
What First Principles Estimating Actually Means
First principles estimating (also called trade-by-trade estimating or elemental estimating) builds the project cost from component parts. You take off quantities, apply rates to those quantities, build up each trade package from the material and labour level, and sum the result.
The logic is direct: if you know what everything costs and you've measured everything accurately, your estimate reflects the actual cost of building that specific project. There are no borrowed assumptions from other jobs, no benchmarks that may not apply, and no averaging that smooths over the particulars of this site, this design, and this client.
First principles estimating is slower. On a complex residential project, a thorough first principles estimate takes 20–40 hours of estimating time. That investment is the price of accuracy.
What Square Metre Rate Estimating Actually Means
Square metre rate estimating applies a cost per square metre of gross floor area — or sometimes per square metre of specific elements like slab, roof, or external wall — based on historical data, industry benchmarks, or a combination of both.
The logic is efficiency: if similar projects cost a known amount per square metre, and this project is similar, the rate is a reasonable proxy for the cost. A quick multiplied estimate can be produced in hours or minutes, rather than days.
Square metre rate estimating is faster. And for the right application, that speed is legitimate value. For the wrong application, it's a shortcut to underquoting.

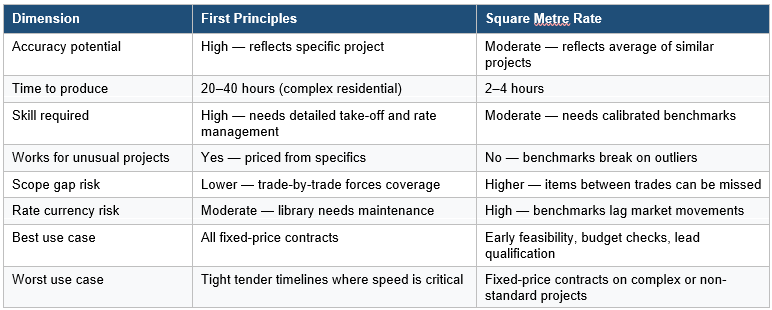

Side-by-Side: Method Comparison

Where Square Metre Rates Earn Their Place
Square metre rates aren't wrong. They're wrong for the wrong application. Used appropriately, they're one of the most efficient tools in an estimator's toolkit.
Lead Qualification
When a prospective client describes a project and asks whether it's in their budget range, a quick square metre rate check is entirely appropriate. You're not pricing the job — you're assessing whether a full estimate is worth doing. A 10-minute rate-based sanity check saves 30 hours of estimating on a project that was never going to happen at the client's budget.
Feasibility Assessment
Early in a project's development — before design is finalised, before engineering is done, before specifications are written — a rate-based estimate is the right tool. It gives clients and designers a realistic cost envelope to work within. The first principles estimate comes later, when the project is defined enough to price properly.
Budget Benchmarking
When reviewing a complete first principles estimate, a square metre rate benchmark is a useful sanity check. If your detailed estimate lands at $3,200/m² for a project type that typically costs $2,400–$2,800/m², that's a signal to review the estimate carefully — either the project genuinely is more expensive, or there's an error somewhere that's inflating the cost.
Rapid Allocation in Preliminary Schedules
In construction programmes, preliminary cost allocation across multiple work packages — before full documentation is available — often uses rate-based estimating as a placeholder. That's its function: to hold a position until the numbers can be done properly.
Where First Principles Is Non-Negotiable
Any fixed-price contract that's going to be signed should be underpinned by a first principles estimate. Not a rate check. Not a benchmark comparison. A project-specific, take-off-based, trade-by-trade cost build-up.
The reason is simple: a square metre rate is the average cost of building a set of past projects. Your contract is for this project — and this project has its own site, its own design, its own specification level, its own trade market, and its own risks. The average rate may be a reasonable approximation. Or it may be 15% off. Once the contract is signed, you own the difference.
The Most Dangerous Hybrid: The Adjusted Rate
The single most common margin-destroying estimating practice in Australian residential construction is what we call the adjusted rate: taking a square metre benchmark and making mental adjustments for the project's specific features. "This one has a complex roof so I'll add 5%... the site is sloped so I'll add another 3%..." and so on until the estimator has convinced themselves that the adjusted number is close enough.
It rarely is. Mental adjustments to benchmarks systematically understate the magnitude of deviation from the average case. Humans are bad at intuitively compounding percentage adjustments, and estimating pressure pushes toward optimism rather than accuracy. The adjusted rate is the worst of both worlds: the speed of a rate estimate without the safety structure of first principles.
A Worked Example: The Same Project, Both Methods
Consider a 250m² custom home on a sloped block in outer suburban Melbourne. Architectural design is above average specification. There's a small retaining wall and a stepped slab required by the slope.
Square Metre Rate Approach
Industry benchmark: $2,800/m² for above-average spec residential in Melbourne. Adjust upward for slope and complexity: $3,100/m². Estimated project cost: $775,000.
Time to produce: 2 hours.
First Principles Approach
Substructure: stepped slab with retaining wall is $85,000 — not the $45,000 a standard flat-slab equivalent would cost. Structure, roof, and cladding: $210,000. Services: $180,000 (above average spec means above average fit-out). Joinery and finishes: $145,000. Prelims: $65,000 (sloped access, scaffolding more complex). External works: $45,000. Margin: $95,000. Total: $825,000.
Time to produce: 28 hours.
The gap: $50,000, or 6% of contract value. If the builder prices at the square metre rate and signs a fixed-price contract, that gap comes out of margin. On a project with a 20% target margin, the actual margin is around 14%. That's the cost of the shortcut — paid once, in full, regardless of how well the rest of the project runs.
How High-Margin Builders Use Both Methods
The most profitable Australian builders don't choose between the two methods — they use each for its appropriate purpose:
- Rate estimates at lead qualification: should we bother quoting this?
- Rate estimates at feasibility: is the client's budget realistic?
- First principles for every fixed-price contract without exception
- Rate benchmarks as sanity checks against completed first principles estimates
- Post-job variance reviews to recalibrate rate benchmarks from actual cost data
The last point matters more than most builders realise. Rate benchmarks that are calibrated from your own completed project data are much more accurate than industry benchmarks — because they reflect your cost structure, your supplier relationships, your labour productivity, and your overhead model. Builders who run proper post-job variance reviews and feed the data back into their benchmarks accumulate a genuine competitive advantage over time.
How Software Supports Both Methods
Modern estimating platforms like Wunderbuild and Buildxact support both methods — and importantly, they support the transition between them. A rate-based feasibility estimate can be converted into a first principles estimate by drilling into the components that make up each element. The rate becomes a starting point, and the estimator builds specificity on top of it.
The platforms also support calibration: when actuals are recorded against projects, the underlying rate benchmarks can be refined from real data rather than industry averages. Over time, a builder's own calibrated rate library becomes a more accurate tool than any external benchmark.
The Bottom Line
Square metre rates are a legitimate estimating tool for the purposes they're designed for: fast feasibility assessment, lead qualification, and early budget discussions. They are not an appropriate basis for fixed-price contracts on projects with any meaningful deviation from the average.
First principles estimating is slower and more expensive to produce — and it's the only method that gives you genuine confidence in the number you're signing a contract around. For Australian builders serious about protecting margin, the discipline isn't to choose one method over the other. It's to know exactly which to use, and never to use a square metre rate where first principles is required.
A square metre rate tells you what similar projects cost. First principles tells you what this project costs. On a fixed-price contract, this project is what you're building.
Want an estimating method review? We'll assess how your business currently uses both methods and identify where the risk is concentrated — before it shows up in a post-contract cost overrun. Book your review.
Ready to quote faster?
Book a free 15-minute call with our team and we'll show you how Campbells fits your workflow.
Book a Free CallLatest Posts
